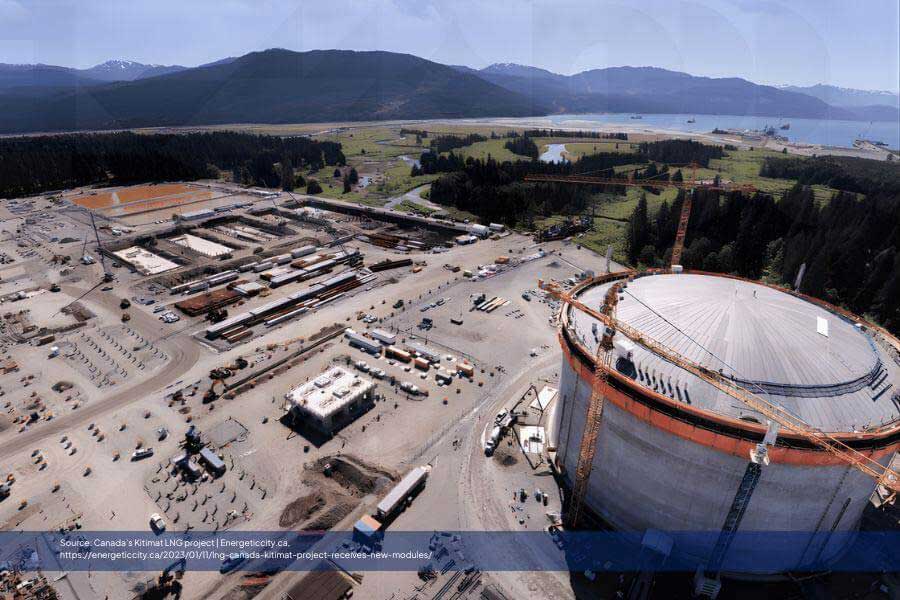

Executive Summary
LNG Canada Phase 2 represents a $33 billion CAD expansion of Canada's first large-scale LNG export facility, positioned to double production capacity and establish Canada as a major global LNG supplier. The Major Projects Office priority designation provides a streamlined two-year approval pathway. Haisla Nation partnership from Phase 1 provides an Indigenous engagement foundation, though expansion requires updated consultation and environmental assessment.
Project Overview
- June 2025: Phase 1 first LNG cargo shipped
- August 2025: FEED contract awarded to Fluor Corporation–JGC Corporation joint venture
- June 2026: Fluor-JGC joint venture received Limited Notice to Proceed (LNTP) for Phase 2, permitting early site preparation, procurement and design work ahead of Final investment decision (FID)
- Late 2026/Early 2027: Final investment decision target
- 2025-2026: Engineering work, regulatory preparation, Indigenous consultation
- Post-FID: 5-7 year construction timeline
- Early 2030s: Commercial operations target
Phase 2 adds two LNG processing trains to the existing infrastructure, doubling facility capacity from 14 million tonnes per annum (mtpa) to 28 mtpa. Phase 1 achieved its first cargo export in June 2025, with more than 50,000 Canadians directly contributing to construction. A further 25,000+ Canadians were employed on the connecting Coastal GasLink pipeline.
Expansion leverages existing site infrastructure, including the marine terminal, administration facilities, and utilities. Phase 2 equipment would be fabricated as modules (similar to the Phase 1 approach) and transported to the site for assembly, reducing on-site construction complexity.
Investment Value
Phase 1: Approximately $40 billion CAD (US$31 billion), comprising roughly $18 billion for the Kitimat processing facility itself and $14.5 billion for the connecting Coastal GasLink pipeline, together representing the largest private infrastructure investment in Canadian history.
Phase 2: Estimated at a further $30 billion to $33 billion CAD, with structural scope costs alone upwards of $10 billion to double production capacity, pending a final investment decision. The project is expected to attract $33 billion in private-sector capital to Canada.
Cost Structure:
- Engineering and design
- Module fabrication (international and Canadian)
- Marine transport and installation
- On-site assembly and commissioning
- Grid connection and utilities
- Contingencies
Timeline & Milestones
-
June 2025: Phase 1 first LNG cargo shipped
-
2024: FEED contract awarded to engineering consortium Fluor Corporation and JGC Corporation on August 2025.
-
Late 2026/Early 2027: Final investment decision (FID) target
-
2025-2026: Engineering work, regulatory preparation, Indigenous consultation
-
Post-FID: 5-7 year construction timeline
-
Early 2030s: Commercial operations target
Critical Path Dependencies:
- Global LNG market conditions and long-term offtake agreements
- BC Hydro electricity availability for low-carbon operations
- Confirmation of permit and monitoring conditions applicable to Phase 2 construction
- Indigenous consultation completion
- Partner consortium FID alignment
Indigenous Partnerships & Consultation
Phase 1 Results:
- $4.1 billion CAD to Indigenous and local businesses (Phase 1)
- HaiSea Marine joint venture: $500 million tugboat services contract (majority Haisla-owned, in partnership with Seaspan)
- Employment and training programmes
- Community investment initiatives
- MNT Investments equity option: five First Nations (Gitga'at, Gitxaała, Haisla, Kitselas and Kitsumkalum) have been offered an equity option of up to C$1 billion to acquire a majority stake in a special-purpose entity that would own the planned Phase 2 storage tank, conditional on FID
Phase 2 Requirements:
- Updated benefit agreements reflecting expanded scope
- Additional employment and procurement commitments
- Environmental monitoring participation
- Community infrastructure investments
Coastal GasLink Pipeline Context
Supply Infrastructure: 670 km pipeline delivers natural gas from northeastern BC
Indigenous Engagement: 10% equity participation offered to First Nations along route
Construction Experience: Faced delays due to Indigenous opposition in certain territories; completed through benefit agreements and extended consultation
Learning Applied: Phase 2 consultation informed by Phase 1 and Coastal GasLink experiences
Treaty & Rights Framework
Legal Context: Operating on Crown lands within Haisla traditional territory
Consultation Standard: Section 35 Constitution Act obligations; UNDRIP principles
Marine Access: Douglas Channel vessel traffic consultation with coastal First Nations
Precedent: LNG Canada established consultation model for BC LNG sector
Regulatory & Approval Status
Major Projects Office Designation
Announcement: September 11, 2025 (first tranche of Major Projects Office priorities)
Significance: Two-year maximum approval timeline; coordinated federal review
Process: Single-window federal coordination; "one project, one review" with BC government
Environmental Assessment
Phase 1 Certificate: Received June 2015 from the BC Environmental Assessment Office, amended August 2016, October 2019, February 2021, and November 2022 to reflect specific project changes within its certified scope.
Phase 2 Requirement: Covered under the original four-train scope of Certificate #E15-01 and the July 2016 federal Decision Statement, with Phase 2 expected to proceed via further amendment to the existing Certificate rather than a new environmental assessment.
Key Issues:
-
Greenhouse gas emissions (incremental from expansion)
-
Marine vessel traffic impacts
-
Air quality in Kitimat area
-
Water use from Kitimat River
-
Cumulative effects with Phase 1
Federal Approvals Required
- Fisheries Act authorisations
- Navigation Protection Act approvals
- Species at Risk Act considerations
- Federal lands and waters permits
Provincial Approvals Required
- BC Environmental Assessment Certificate update
- Provincial permits (air, water, waste)
- Municipal development permits (District of Kitimat)
Technical Specifications
Capacity & Production
Phase 2 Addition: 14 mtpa (two trains × 7 mtpa each)
Total Facility: 28 mtpa (four trains total)
Processing: Natural gas liquefaction to -162°C
Storage: Existing tanks plus potential additional capacity
Loading: Dual LNG carrier berths (existing infrastructure)
Emissions Profile
Competitive Advantage: 35% lower emissions than world's best-performing LNG facilities; 60% lower than global average
Low-Carbon Pathway:
- BC Hydro renewable electricity (when available)
- Energy-efficient natural gas turbines
- Best-in-class liquefaction technology
- 0.15 tonnes CO2e per tonne LNG projected emissions intensity for Phase 1 and Phase 2 combined, operating together at full capacity, versus a global average of 0.35 tonnes CO2e per tonne
- Electrification Dependency: Phase 2 economics and emissions performance depend on BC Hydro electricity availability; constraints force reliance on natural gas turbines, reducing competitive advantage
Infrastructure
Site: 400 hectares Kitimat Industrial Site
Marine Terminal: Deep-water access, ice-free harbour
Rail: Condensate loading via existing rail infrastructure
Workers: Accommodation and facilities from Phase 1
Utilities: Water treatment, flare systems, administration buildings (expandable)
Market Positioning & Export Strategy
Target Markets
Primary: Asian LNG importers (Japan, South Korea, China, Taiwan)
Secondary: European markets seeking supply diversification post-Russia-Ukraine
Advantage: Pacific coast location provides shorter shipping distances to Asia versus US Gulf Coast LNG
Competitive Positioning
Low-Carbon Intensity: Marketing advantage in emissions-conscious markets; European buyers prioritising lower-carbon LNG
Supply Security: Canadian political stability and rule of law; North American gas reserves reliability
Price Competitiveness: Montney Formation gas costs; operational efficiency from Phase 1 learnings
Long-Term Offtake
FID Requirement: Phase 2 partners require long-term sales agreements before committing capital
Market Dynamics: Global LNG demand growth; Asian energy security priorities; European supply diversification
Competition: US Gulf Coast LNG expansions; Qatar mega-projects; Australian LNG
Employment & Economic Impact
Construction Phase
Peak Employment: 10,000+ jobs during major construction
Duration: 5-7 years construction phase
Canadian Content: 80%+ of workforce expected to be Canadian
Trades: Heavy emphasis on skilled trades (pipefitters, electricians, millwrights, ironworkers)
Operations Phase
Permanent Jobs: Hundreds of permanent positions (operations, maintenance, administration)
Indirect Employment: Supply chain, services, contractors
Skills: Highly skilled technical roles; competitive salaries
Indigenous Employment
Commitments: Minimum Indigenous employment percentages in agreements
Training: Workforce development programs (Phase 1 invested $10+ million CAD)
Businesses: Continued procurement from Indigenous-owned businesses
Career Pathways: Trades training programs for local and Indigenous residents
Fiscal Benefits
Government Revenue: $23 billion CAD direct benefits to BC government over project life (provincial estimate)
Property Taxes: Significant contributions to the District of Kitimat
Procurement: Local and Canadian businesses; Phase 1 exceeded $5 billion CAD to BC businesses
Key Investment Risks
Material Risks
Electrification Constraints
- Issue: Phase 2 low-carbon advantage depends on BC Hydro electricity availability
- Current Status: BC facing electricity capacity constraints; drought impacts on hydroelectric generation
- Impact: Without sufficient renewable power, the facility relies on natural gas turbines, reducingthe emissions advantage
- Mitigation: Provincial government aware of benefits; discussions are ongoing about power allocation
Global LNG Market
- Issue: FID contingent on long-term offtake agreements; LNG prices volatile
- Competition: US Gulf Coast expansions; Qatar North Field projects; Australian capacity
- Asian Demand: Economic growth uncertainties; renewable energy transition pace
- Mitigation: Canadian LNG's low-carbon profile; Asian energy security priorities
Indigenous Consultation
- Issue: Phase 2 requires updated consultation beyond Phase 1 agreements
- Coastal Nations: Vessel traffic concerns from marine-focused First Nations
- Cumulative Effects: Douglas Channel traffic increasing with multiple LNG proposals
- Mitigation: Established Haisla relationship; Phase 1 consultation experience; HaiSea Marine partnership demonstrates Indigenous economic participation, strengthened by the newly confirmed MNT Investments equity option
Environmental Assessment
- Issue: Regulatory pathway for Phase 2 (Certificate amendment versus new assessment) not yet explicitly confirmed by LNG Canada or the BC EAO, though existing evidence points toward amendment; cumulative effects scrutiny remains relevant regardless of pathway
- Timeline: Could extend if compliance, permitting, or amendment review issues arise
- Public Opposition: Environmental groups challenging LNG sector expansion; specific concerns from coastal and marine-focused First Nations regarding vessel traffic and cumulative effects
- Mitigation: Major Projects Office two-year timeline commitment; established Certificate amendment precedent (four amendments processed 2016-2022 without a Community Advisory Committee or extended public engagement, on the basis of limited scope)
Capital Cost Escalation
- Issue: Global inflation; supply chain constraints; labour costs
- Phase 1 Experience: Project completed but faced cost pressures
- Impact: Could affect FID if returns insufficient
- Mitigation: Module fabrication approach; established supply chains; Phase 1 learnings
Moderate Risks
Regulatory Coordination
- Federal-provincial-municipal coordination requirements
- Multiple permit streams requiring alignment
- Major Projects Office coordination intended to mitigate
Construction Labour
-
Skilled trades availability in tight labour market
-
Remote location challenges for workforce
-
Accommodation and logistics
Partner Alignment
- Five international companies must align on FID
- Each partner's corporate priorities and market perspectives
- Consensus decision-making requirements
Investment Opportunities & Strengths
Regulatory Advantages
Major Projects Office: Streamlined two-year approval pathway; federal priority support
Precedent: Phase 1 successful completion demonstrates Canadian ability to deliver large-scale LNG
Provincial Support: BC government LNG-friendly policies; tax frameworks
Commercial Strengths
Established Infrastructure: Phase 2 leverages Phase 1 investment reducing capital intensity
Operator Expertise: Shell's global LNG leadership; experienced partner consortium
Market Access: Deep-water ice-free harbour; Douglas Channel shipping route established
Cost Learning: Phase 1 construction experience applied to Phase 2 reducing execution risk
Strategic Value
Supply Diversification: Reduces global reliance on specific LNG suppliers
Canadian Economy: Tens of billions in private investment; thousands of jobs; government revenues
Indigenous Reconciliation: Economic participation model for Indigenous communities, strengthened by the MNT Investments development
Energy Security: Reliable North American supply for energy-importing nations
Financial Structure Options
Private Financing: Partners expected to fund through corporate resources and project finance
Federal Support: Canada Infrastructure Bank potential involvement; federal loan guarantees
Indigenous Participation: Future tranches could include Indigenous equity; Indigenous Loan Guarantee Program access
Investment Intelligence Summary
Risk Profile: Moderate (established Phase 1 foundation, but market and electrification uncertainties)
Timeline: FID 2026-2027; operations early 2030s (realistic scenario)
Probability: High (60-70%) given Major Projects Office support, established infrastructure, partner commitment
Investment Thesis: Best-positioned LNG expansion in Canada; Phase 1 demonstrated execution capability; low-carbon advantage in evolving market
UK/European Investor Considerations:
- European LNG demand increasing post-Russia; Canadian supply attractive
- Low-carbon intensity aligns with European emissions standards
- Political stability and rule of law reduce sovereign risk versus other LNG suppliers
- Indigenous partnership model demonstrates social license strength
- Major Projects Office support signals federal commitment
Due Diligence Priorities:
- Monitor FID decision timing and partner alignment
- Track BC Hydro electricity allocation decisions
- Assess the long-term offtake agreement progress
- Review Phase 2 environmental assessment process
- Evaluate global LNG market supply-demand dynamics
- Monitor MNT Investments equity option progress and confirm terms once FID is reached
Sources
- Canada.ca — LNG Canada Phase 2, Major Projects Office
- EnergyNow — LNG Canada Phase Two Draws Closer
- EnergyNow — LNG Canada Nears Crucial Phase 2 Decision
- LNG Industry — LNG Canada advance proposed Phase 2 expansion
- CBC News — Carney recommends 5 nation-building projects
- Petroleum & Gas Journal — LNG Canada Offers Indigenous Group $711 Million Stake
- Seaspan — Haisla Nation and Seaspan Awarded LNG Canada Escort and Harbor Tugs Contract
- LNG Canada — Haisla Nation and Seaspan awarded escort and harbor tugs contract
- Daily Hive — BC First Nations acquire equity in Coastal GasLink
- The Narwhal — Coastal GasLink pipeline (CGL): News and Updates
- CBC — First Nations plan to buy stake in Coastal GasLink pipeline
- LNG Canada — Construction
- Government of British Columbia — LNG Canada
- LNG Canada — The Path to First Cargo
- Fluor Corporation — Fluor Joint Venture Receives Limited Notice to Proceed for Proposed Phase 2 Expansion of LNG Canada Facility
- LNG Canada — Enhanced Investment Co-operation Advances Efforts Around LNG Canada's Proposed Phase 2 Expansion
- Yahoo News Canada (Vancouver Sun) — New signs emerging that LNG Canada 2 investment decision in works
- Canadian Indigenous Investment Forum — LNG CANADA PHASE 2 (KITIMAT, BC)
- LNG Canada — Workforce Development
- LNG Canada — LNG Canada Project Mid-Year Update Summer 2023
- JGC Holdings Corporation — JGC and Fluor awarded FEED contract for Proposed Second Phase LNG Canada Facility Expansion
- Fluor Corporation — Fluor Joint Venture Awarded Front End Engineering and Design for Proposed Second Phase of LNG Canada Facility
- International Institute for Sustainable Development — How Canadian LNG Impacts the Climate
- BC Energy Regulator — LNG Canada
- BC Environmental Assessment Office — LNG Canada Amendment #4 Assessment Report (29 November 2022)
- BC Environmental Assessment Office — Order, Amendment #4 to Certificate #E15-01 (29 November 2022)
- justandreasonable.com — LNG Canada
